PEIMS Extended Year Submission

The ASCENDER District Administration application provides program data for each collection from the ASCENDER Business and Student system. These programs are reviewed and modified annually, per the published Texas Web-Enabled Data Standards (TWEDS), to ensure that the data sent to the district database is as accurate as possible.

The PEIMS Extended Year Submission includes data for leavers, graduates, certain programs, and course completions:

  • Extended School Year (ESY) services provided to special education students,
  • Flexible attendance for Optional Flexible School Day Program (OFSDP) Credit/Promotion Recovery Program,
  • Bilingual/ESL Summer School Program
  • Additional Days School Year (ADSY) Program,
  • Additional Instructional Days for Reading Intervention,
  • Course completions between school years for:
    • High school Career and Technical (CTE) courses,
    • Dual credit courses,
    • College Preparatory Course English Language Arts, and
    • College Preparatory Course Mathematics.

This guide is organized in domain dependency order.

The Extended Year submission is due August 27, 2026.

IMPORTANT: Some of the images and/or examples provided in this document are for informational purposes only and may not completely represent your LEA’s (School System) process.

TIP: How to review, save or print a report.

Prerequisites

Before starting the verification process, ensure the following tasks have been completed within the respective applications:

Security Administration

  • Verify all roles and users are correct.

Grade Reporting

  • Ensure all Summer School course data has been entered.

Verify and Update ASCENDER Data

I. Education Organization

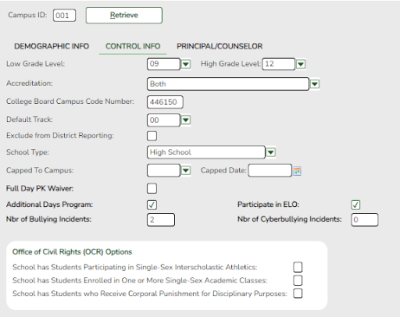

For the PEIMS Extended Year Submission, the Education Organization domain provides information about any public school, charter, education service center, organization or agency.

II. School Calendar

For the PEIMS Extended Year Submission, the School Calendar domain provides calendar information for the Optional Flexible School Day Program (OFSDP) Credit/Promotion Recovery Program, the Extended School Year Program, and the Additional Days School Year Program. It. is dependent on the Education Organization domain.

III. Alternative and Supplemental Services

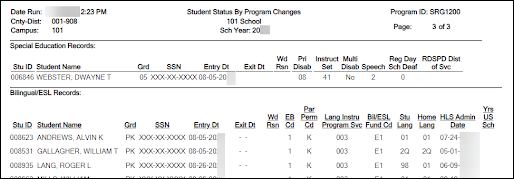

For the PEIMS Extended Year Submission, the Program entity provides program information for Special Education and Emergent Bilingual programs provided by the district. It is dependent on the Education Organization domain.

NOTE: This section is used only to verify district-provided programs. Individual student records are verified and updated in the VI. Student Identification and Demographics section.

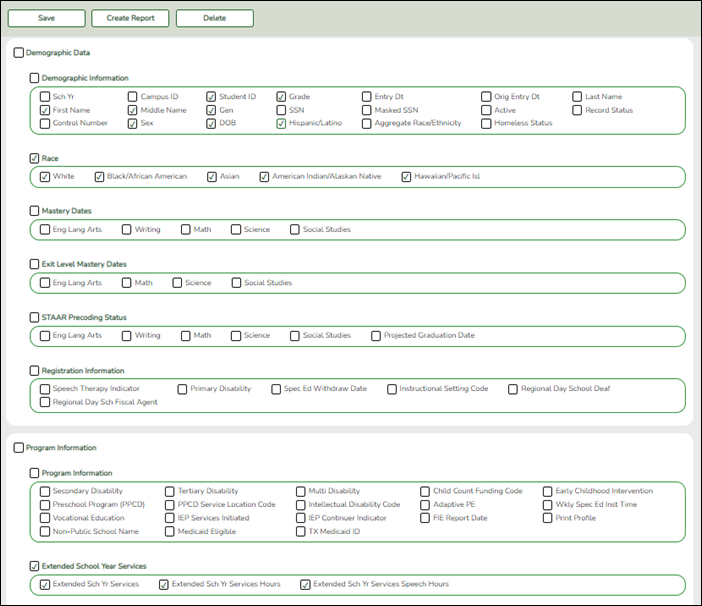

  • Entity
  • Verify Data

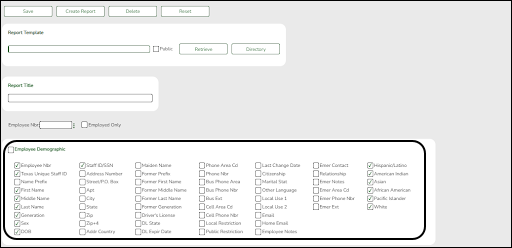

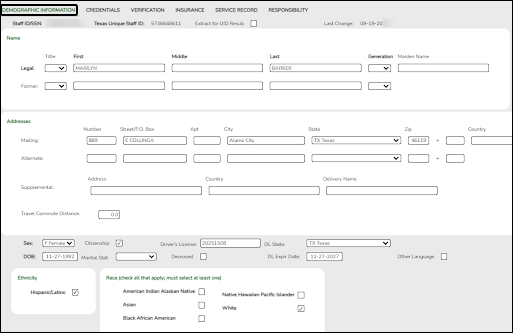

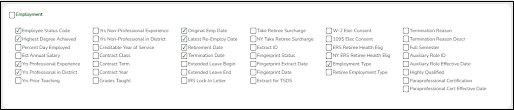

IV. Staff

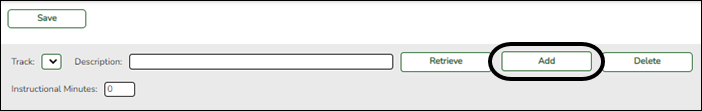

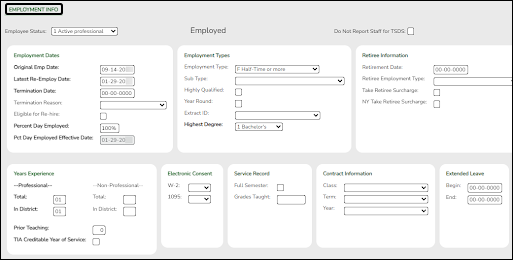

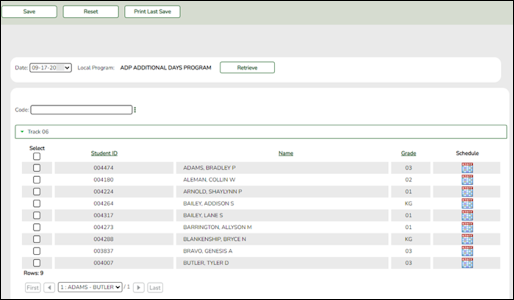

For the PEIMS Extended Year Submission, the Staff domain provides the general staff information for teachers teaching students in the Additional Days School Year (ADSY) Program. It is dependent on the School Calendar domain.

Only teachers teaching students in the Additional Days School Year (ADSY) program with StaffClassification 047 (Substitute Teacher) and 087 (Teacher) should be reported.

  • Entity
  • Verify Data
  • Update Data

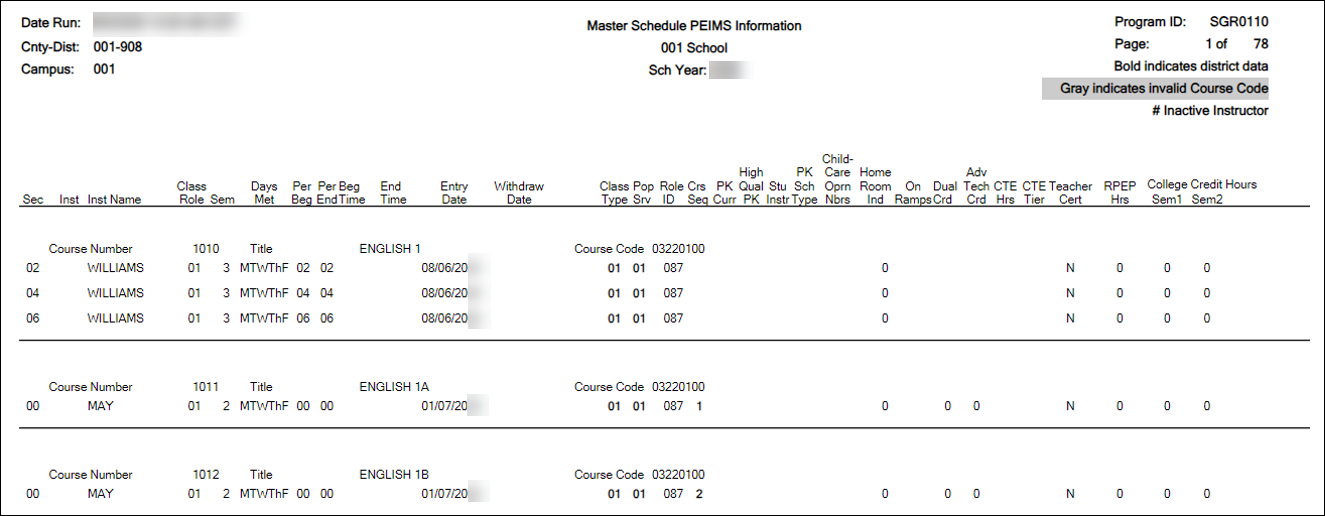

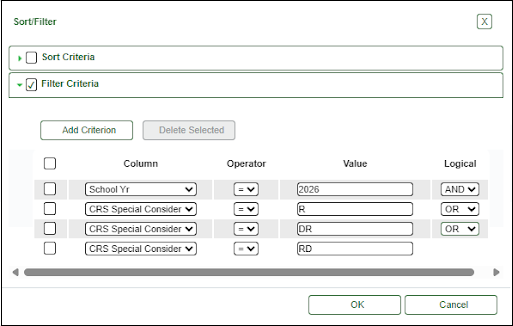

V. Teaching and Learning

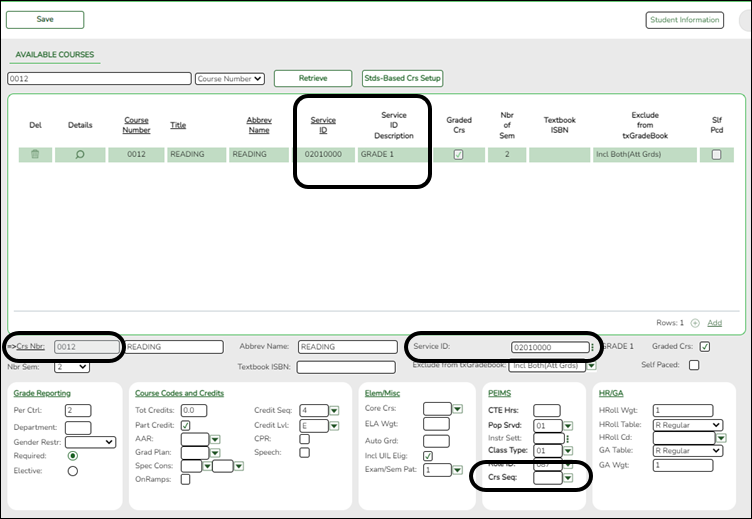

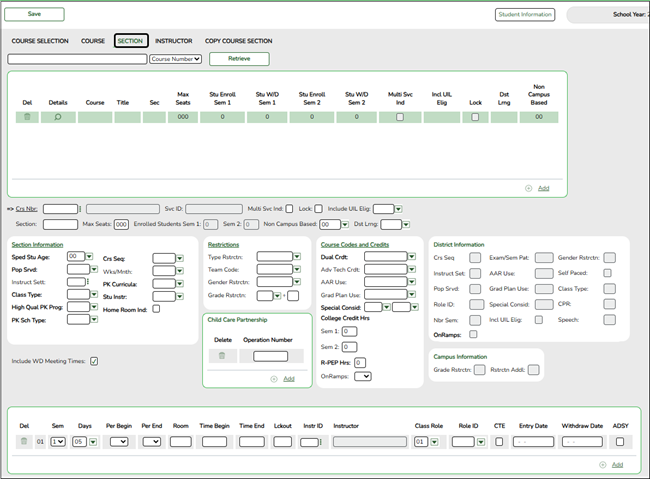

For the PEIMS Extended Year Submission, the Teaching and Learning domain provides course, section, staff assignment, and student enrollment information for eligible summer programs. It is dependent on the both the Staff domain along with the Staff and StaffEducationOrganizationEmploymentAssociation entities.

  • Entities

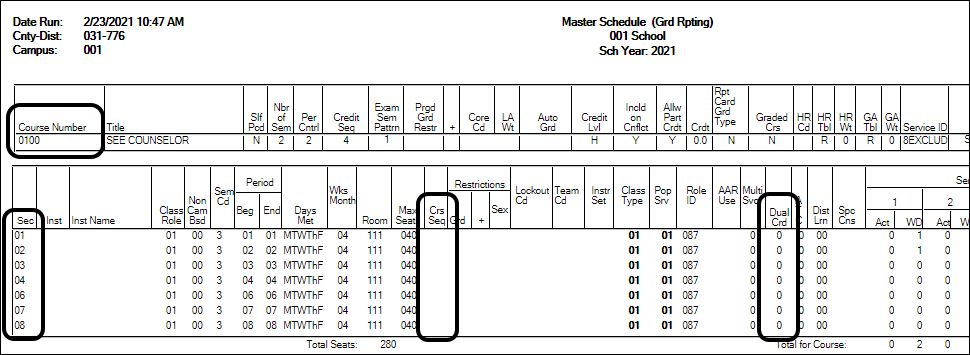

  • Verify and Update Section Entity Data
  • Verify and Update StaffSectionAssociation Entity Data

VI. Student Identification and Demographics

The Student Identification and Demographics domain Parent, Student, and StudentParentAssociation entities provide basic demographic and contact information associated with each student. It is dependent on the School Calendar domain, the Alternative and Supplemental Services domain, and the Program entity.

NOTE: The following students shall be included for the PEIMS Extended Year Submission (4) reporting:

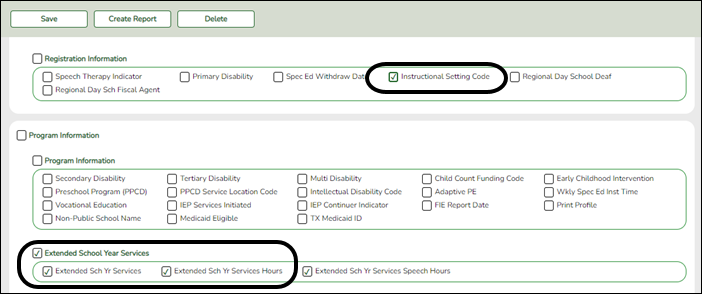

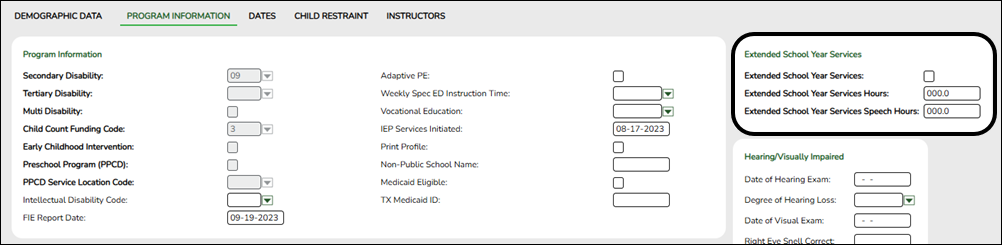

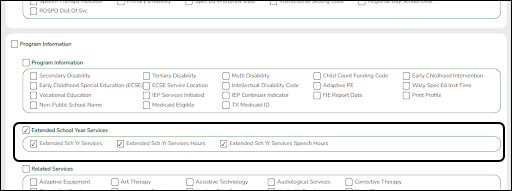

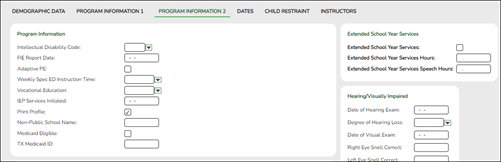

  1. Students who received Extended School Year (ESY) services.
  2. Students who participated in the Bilingual/ESL Summer School program,
  3. Students with flexible attendance,

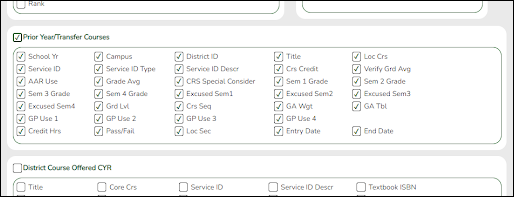

  4. Students who completed a course (CourseCompletionIndicator is true) during the summer (between school years). These courses must fall into one of the following categories:
    • Career and Technical Education (CTE)
    • Dual credit
    • College Preparatory English Language Arts
    • College Preparatory Mathematics
  5. Students who participated in the Additional Days School Year (ADSY) program.
  6. All leavers in grades 7-12 (including students that do not enroll in the LEA within the next year’s school-start window).

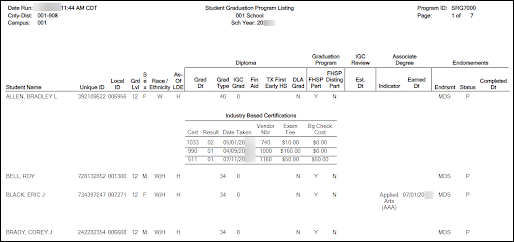

  7. All graduates.
  8. Students in grades 9-12 who earned or passed an IBC exam between June 1 and August 31 of the current school year.
  9. Students in grades 11 and 12 who earned an associate degree in the summer (through August 31).

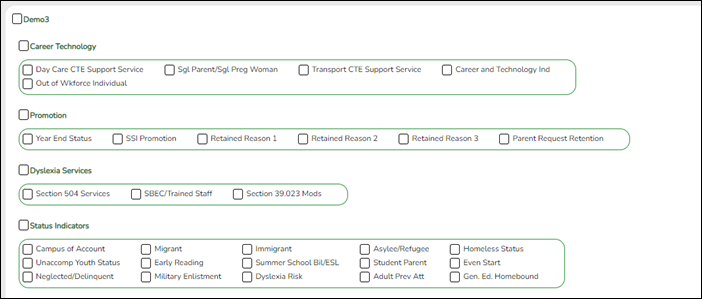

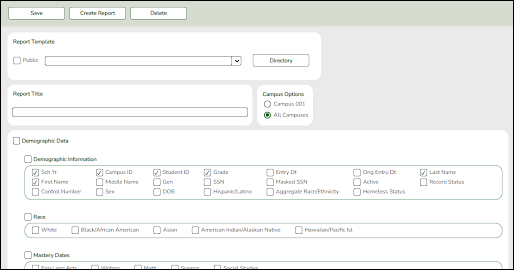

  • Entities

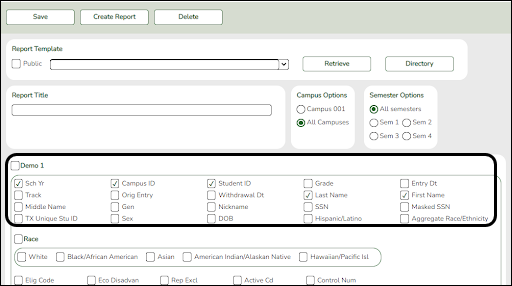

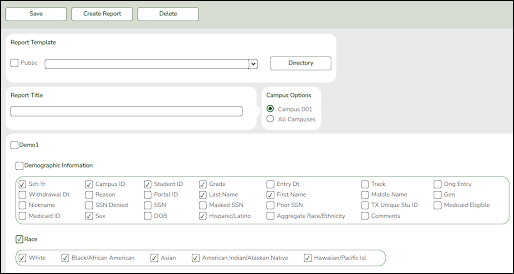

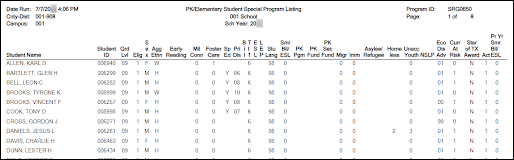

  • Verify and update the students included in the categories for the PEIMS Extended Year Submission:

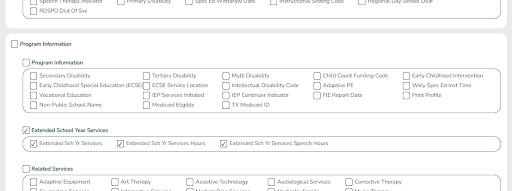

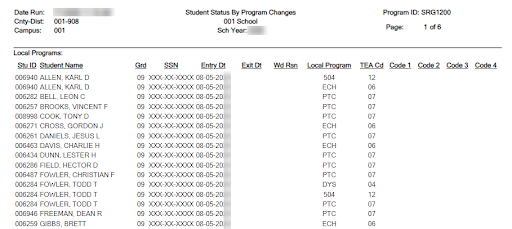

    • Extended School Year (ESY)

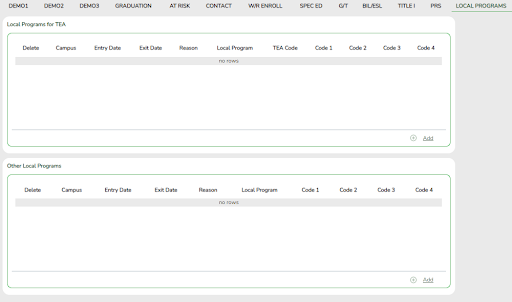

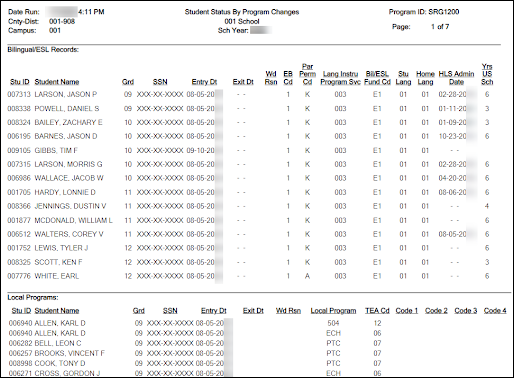

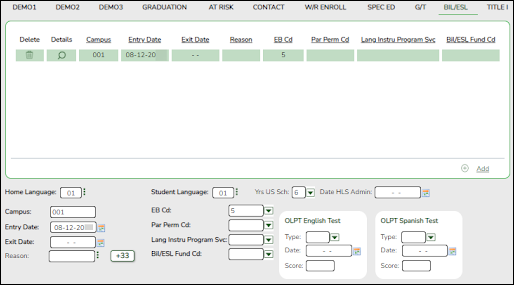

    • Bilingual/ESL Summer School, Flexible Attendance, and ADSY

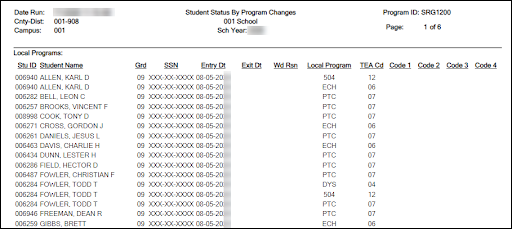

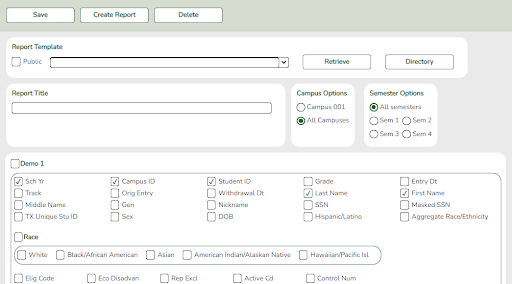

    • Summer Course Completion

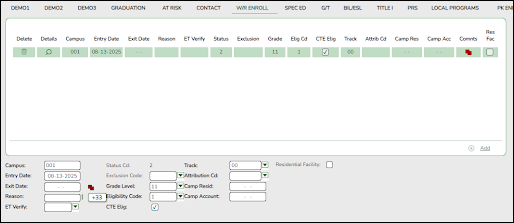

    • Leavers
    • Summer IBC & Associate Degrees

VII. Enrollment

The Enrollment domain provides the enrollment and withdrawal information for a student and the relationship between a particular education organization. It is dependent on the Student Identification and Demographics domain along with the Student, Parent, and StudentParentAssociation entities.

NOTE: The following information only needs to be verified and updated for students included in the PEIMS Extended Year submission.

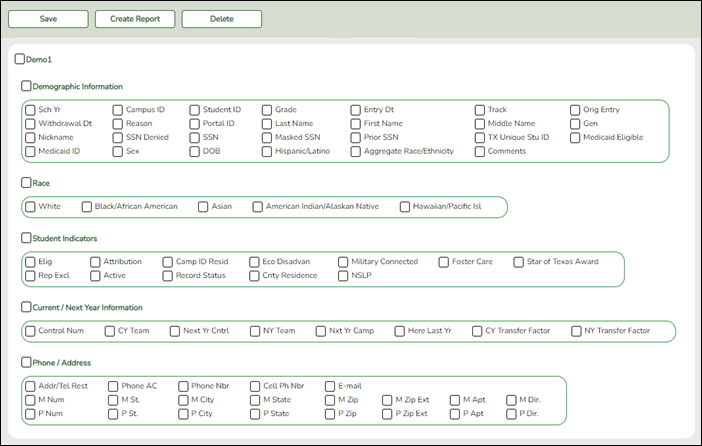

  • Entities
  • Verify

  • Update

VIII. Student Identification and Demographics

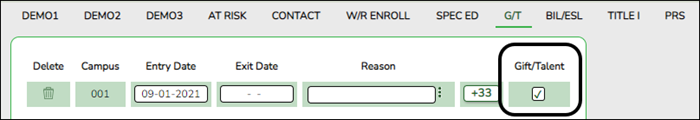

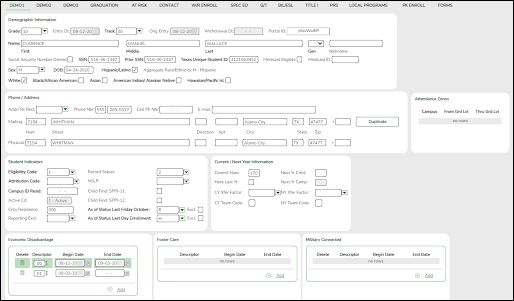

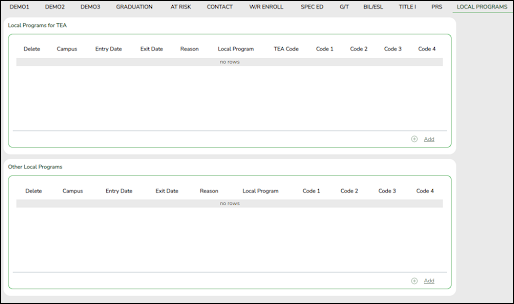

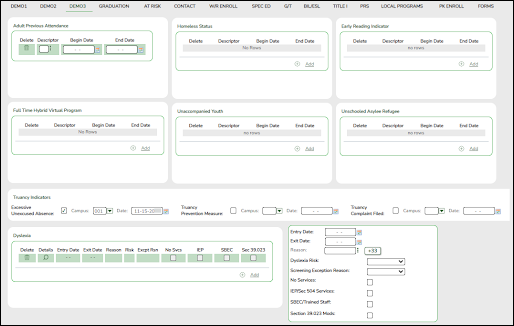

The Student Identification and Demographics domainStudentEducationOrganizationAssociation entity captures demographic and similar characteristics of a student that are specific to a student's relationship with a particular education organization. It is dependent on the Enrollment domain.

NOTE: The following information only needs to be verified and updated for students included in the PEIMS Extended Year submission.

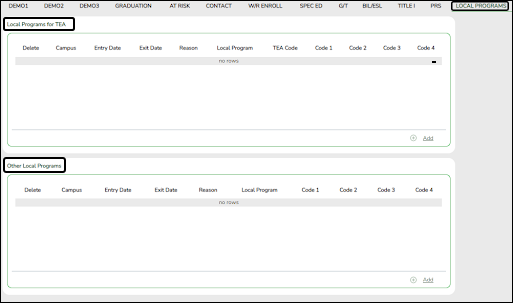

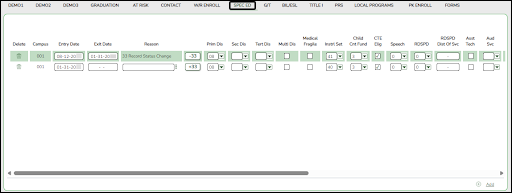

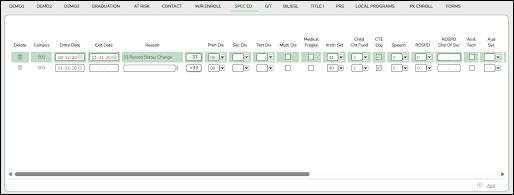

IX. Alternative and Supplemental Services

The Alternative and Supplemental Services domain provides program information such as Title I, Special Education, and Emergent Bilingual. It is dependent on both the Student Identification and Demographics domain and the StudentEducationOrganizationAssociation entity.

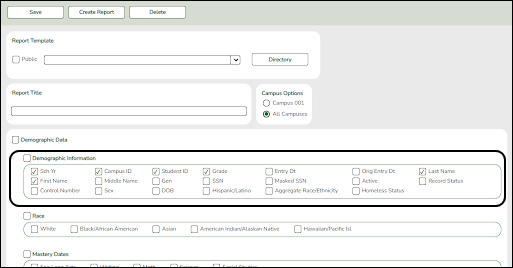

X. Teaching and Learning

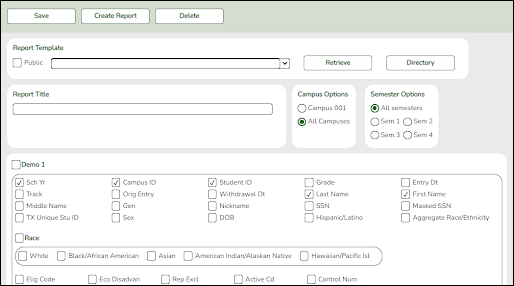

For the PEIMS Extended Year Submission, the Teaching and Learning domain provides course, section, staff assignment, and student enrollment information for eligible summer programs. It is dependent on both the Student Identification and Demographics domain and the StudentEducationOrganizationAssociation entity.

NOTE: This is the same report created to verify the Section entity data in the V. Teaching and Learning section of the guide.

  • Entities
  • Verify
  • Update

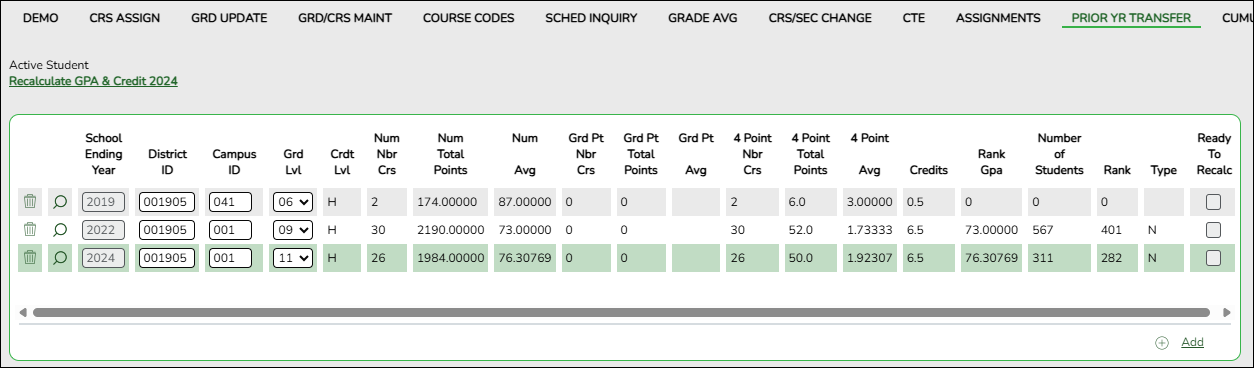

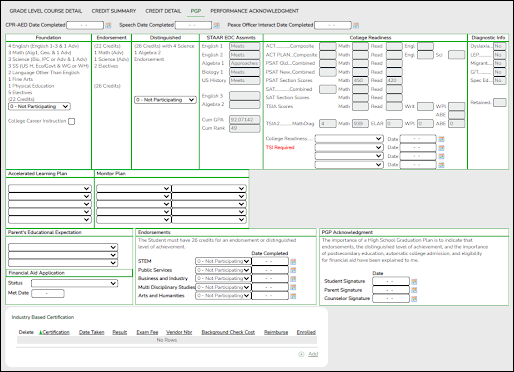

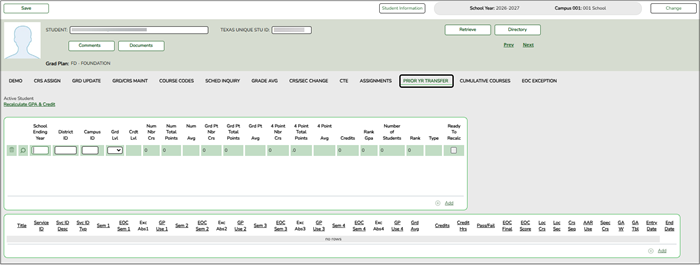

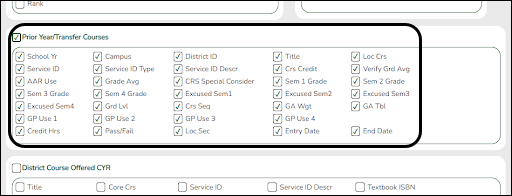

XI. Student Academic Record

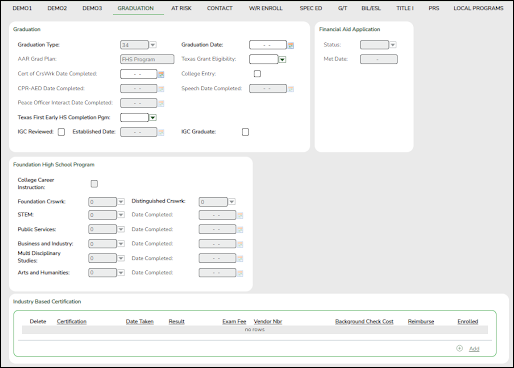

The Student Academic Record domain provides the cumulative record of academic achievement for a student and the final record of a student's performance in their course at the end of a semester or school year. It is dependent on both the Student Identification and Demographics domain and the StudentEducationOrganizationAssociation entity.

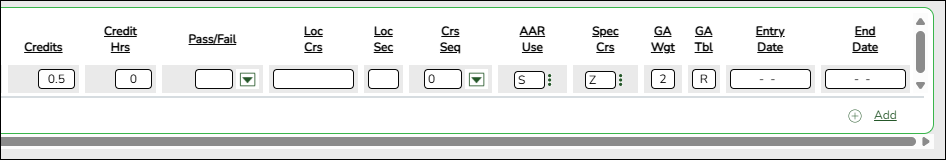

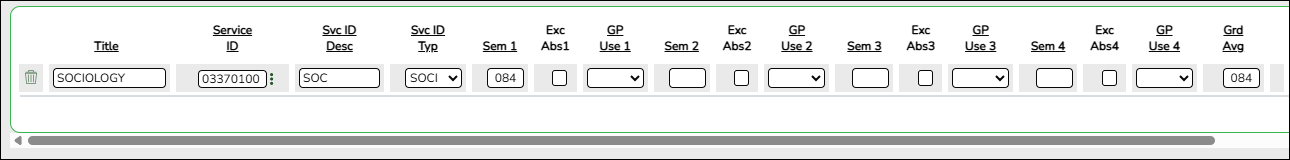

NOTE: In order to be included in transcript extension, a pass-fail indicator that is not blank, 00 or 09 is required on Prior Year Transfer.

This is the same report created to verify the Section entity data in the V. Teaching and Learning section of the guide.

XI. Student Attendance

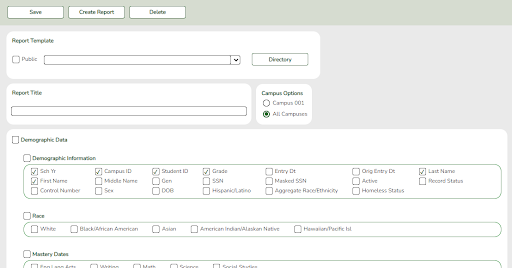

The Student Attendance domain provides the daily attendance information for students. Attendance data for Additional Days School Program (ADSY), Extended School Year, and Optional Flexible School Day Program (OFSDP) Credit Recovery program is reported in this submission. It is dependent on both the Student Identification and Demographics domain and the StudentEducationOrganizationAssociation entity.

  • Entities
  • Verify
  • Update

For a complete list of submission rules and edits, access the TSDS Web-Enabled Data Standards (TWEDS) website. In the top-right corner, select the appropriate School Year (20XX), Collection (XXXX), and Submission (XXX) and click Open.

Once on the TWEDS website, in the Overview tab, you can review Collections, Timelines (DUE DATES), and Data Submission Responsibilities. It is highly important to ensure that you review all of these details as they may change according to the School Year.

Additionally, you can use the other tabs on the TWEDS website to review Data Components, Descriptor Tables, References, Rules, Change Logs, and Early Notices.
